Project Title: Avanade and Ossia - Offline Speech Review and Dysarthric Offline LLM

Check out our GitHub repositories:

Our Partners

Partner 1 Logo
UCL GDIHUB
Partner 2 Logo
OssiaVoice

Abstract

Problem Statement

People with speech and motion disabilities, such as those living with Motor Neurone Disease, face severe communication challenges. OssiaVoice, an AAC (Augmentative and Alternative Communication) tool, currently depends on OpenAI’s API for generating text-based responses. This reliance introduces high costs, internet dependency, and privacy concerns, limiting accessibility for users who require offline functionality. Additionally, there is a need to analyse and compare various offline LLMs to determine the best alternative for OssiaVoice. This was also achieved through our RAG chatbot to mine local research documents for answers and simplify academic research.

Our Solution

The project is structured into two key phases:

Achievement & Impact

By providing an affordable, privacy-conscious, and fully offline AI solution, our project enhances accessibility for individuals with severe speech impairments. This work reduces reliance on costly online services while maintaining high-quality, AI-assisted communication, ultimately improving users’ ability to interact and maintain relationships.

Project video for both phase1 and phase2

Through the video, you will know what our project about, and see our demo showcase.

Development Team

Haocheng Xu

Email: haocheng.xu.23@ucl.ac.uk

Role: Team Leader, Programmer, Researcher, Report Editor

Zizhou Shi

Email: zizhou.shi.23@ucl.ac.uk

Role: Programmer, Researcher, Report Editor

Nigel Mathews

Email: nigel.mathews.23@ucl.ac.uk

Role: UI designer, Programmer, Researcher, Blog Writer, Report Editor

Neethesh Neethesh

Email: t.neethesh.23@ucl.ac.uk

Role: Programmer, Researcher, Report Editor

Project Management - Gantt Chart

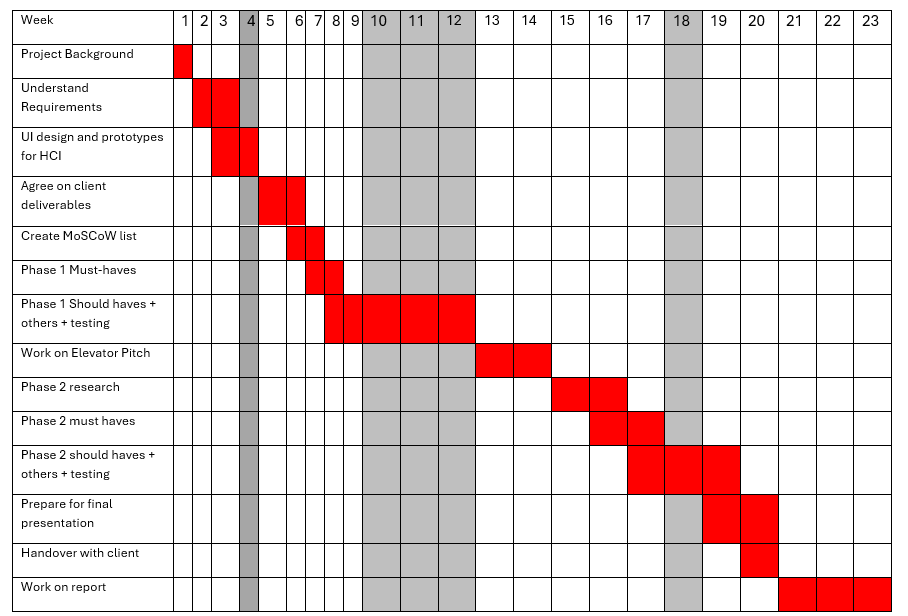

Gantt Chart

This Gantt chart outlines the project's timeline from October 21, 2024, to March 28, 2025.
